Work continues on Silver Creek with traffic on the newly constructed bridge.
Construction at Stewart River will resume in the spring. Traffic is in a head-to-head pattern on the newly constructed bridge through Fall 2023. The Kelsey Beach parking lot will be closed during construction.
There will be no bike or pedestrian access through the construction zone.
About this project
Project location map
Silver Creek Bridge
Construction of new bridge replacing box culvert and including bike/ped crossing on bridge
Stream restoration
Extension of old Hwy 61 to align with Loop Road with sidewalk from bridge to old Hwy 61 extension and provisions for future DNR trail under new bridge
New pavement in work zone
Tree clearing as needed
Stewart River Bridge
Rehabilitation of historic bridge with new bike/ped crossing
Historic bridge will carry northbound TH 61 traffic
Construction of new bridge inland of historic bridge to carry southbound TH 61 traffic
Turn lanes at County Rd 3 and Betty's Pies
New pavement in work zone
Tree clearing as needed
Project maps

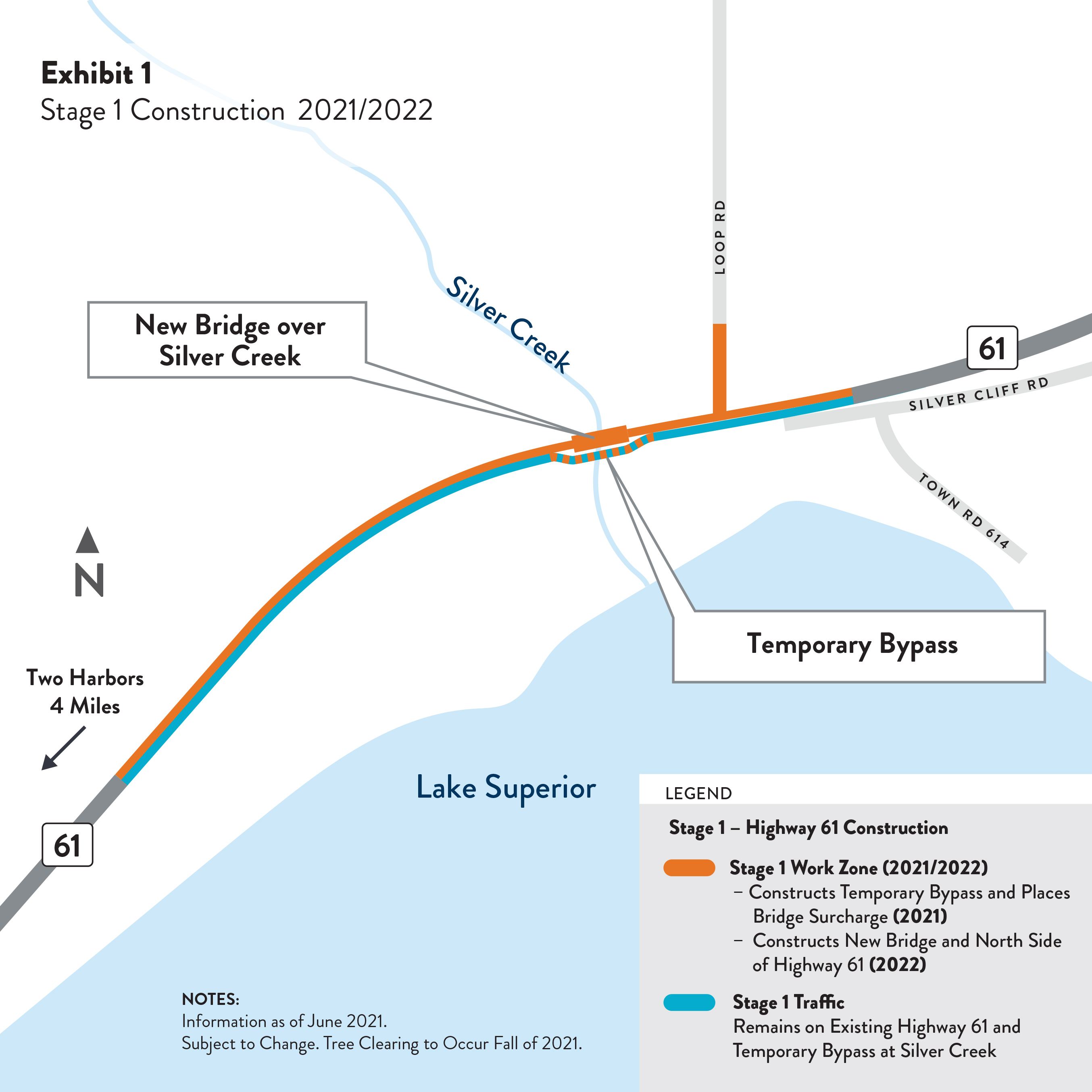

Silver Creek Stage 1 project map. Click to enlarge.

Silver Creek Stage 2 project map. Click to enlarge.

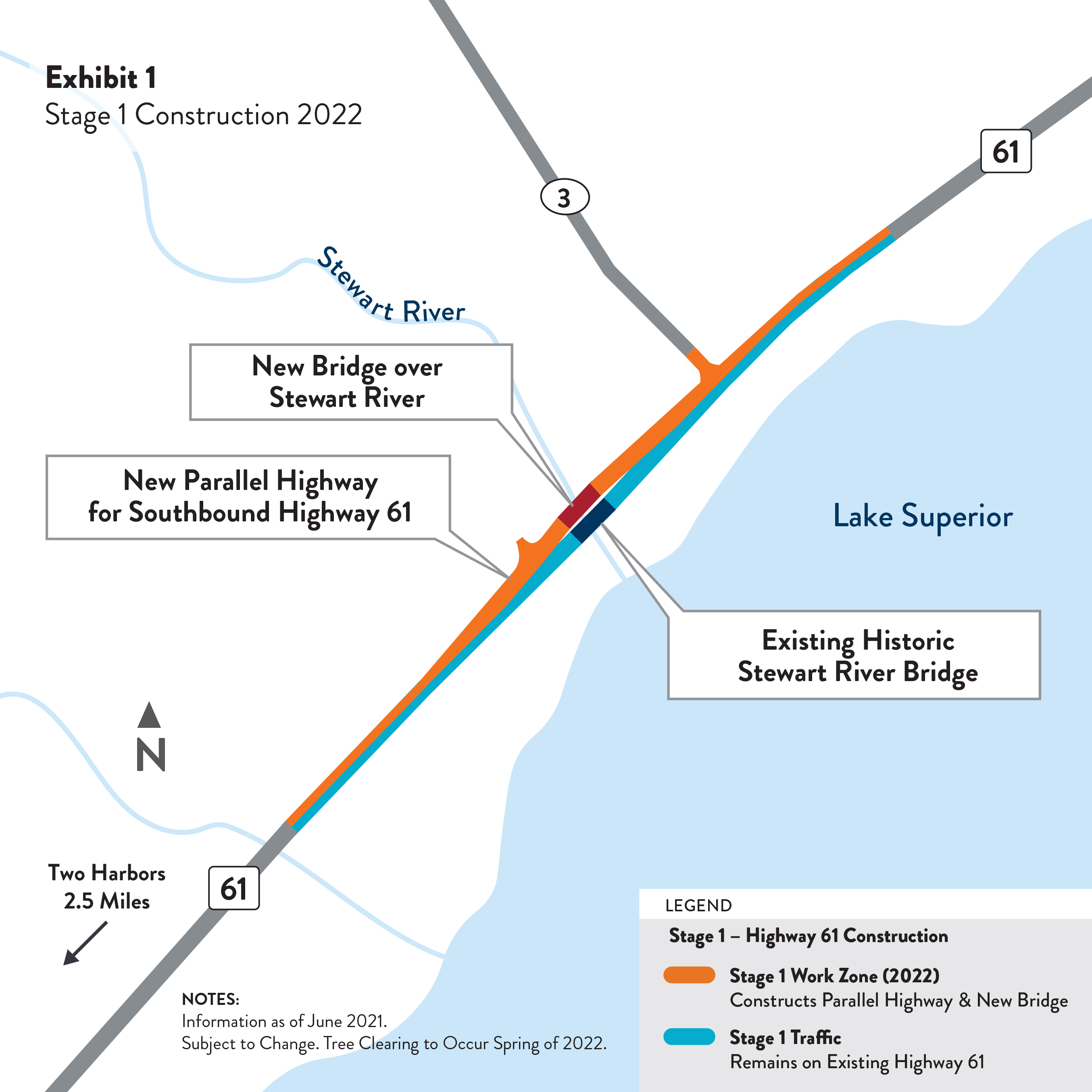

Stewart River Stage 1 project map. Click to enlarge.

Stewart River Stage 2 project map. Click to enlarge.
