Hwy 10 and 23—St. Cloud

Interchange east of the Mississippi River in Benton County

Work, traffic plans

Plan for delays and changes when you travel through this busy interchange area in east St. Cloud from mid-April to mid-November in 2023 and 2024.

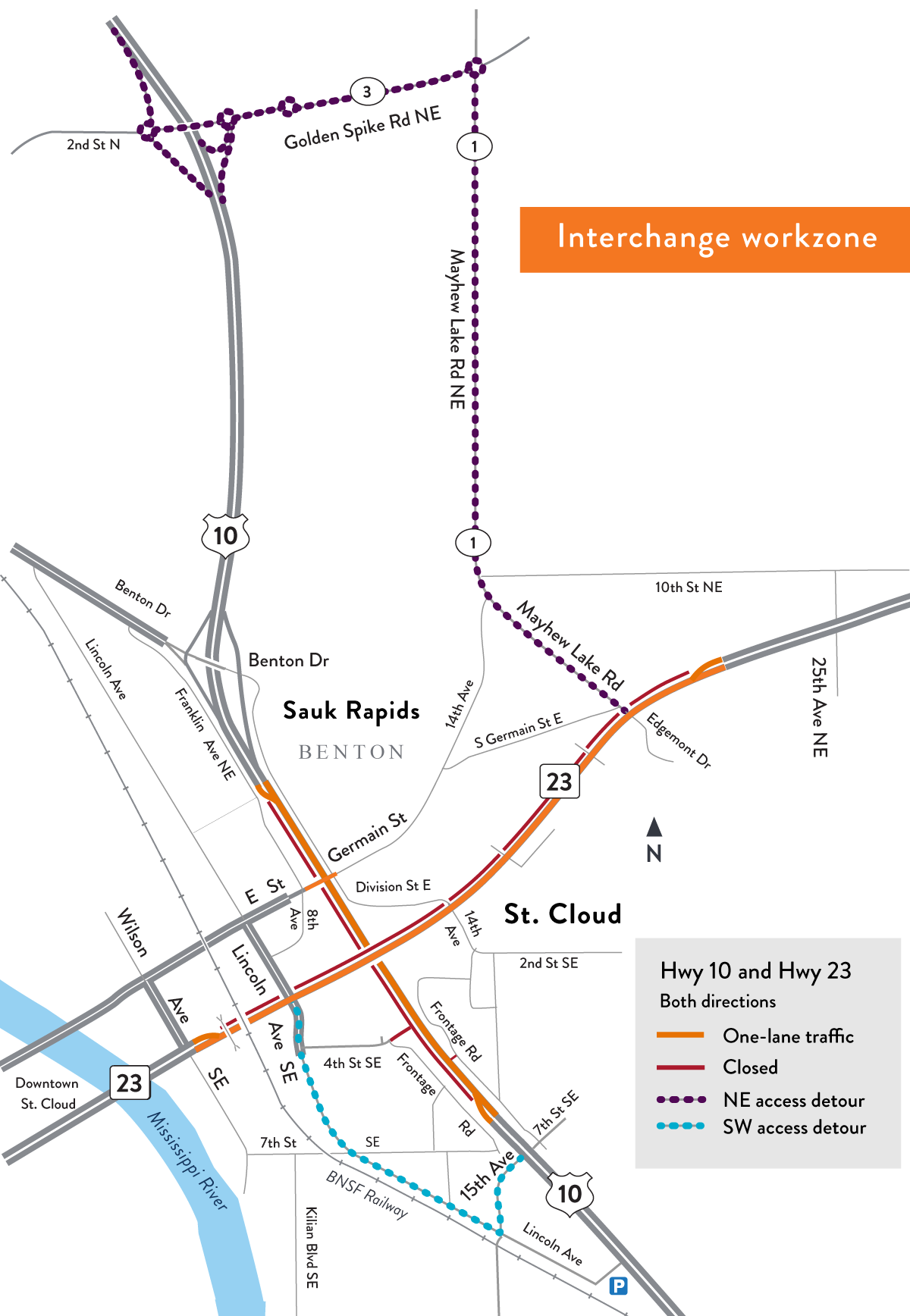

Overall Hwy 10 and 23 will be reduced to one lane in both directions, 24-7, through the interchange workzone each year. The access loops and ramps will close and detour to/from the interchange.

Off-road work to occur year-round. All traffic impacts are tentative and weather dependent. For current impacts visit the home page.

2024 interchange workzone

Work operations will resume in spring 2024. Overall here's what to expect during the final year of mainline construction:

One-lane traffic, each direction, 24/7

  • Hwy 23: Reduced to one lane each direction, 24/7, between Lincoln Ave. SE and 25th Ave. NE.
    • Note: Motorists will use the westbound side as crews reconstruct the eastbound road and bridge over Hwy 10.
  • Hwy 10: Reduced to one lane in each direction, 24/7, between 15th Ave./7th Ave. SE and Benton Dr.
    • Note: Motorists will use the eastbound side as crews reconstruct the westbound road

Interchange access

Access ramps and ramp loops will close and open to/from the interchange

Local travelers

St. Cloud is open

Access will be maintained along the work zone, however expect changes to access. Side streets and entrances will close at times for construction. Follow signs or use alternate routes

Fourth St. SE bridge

Access will close to/from Hwy 10 to construct the new Fourth St. SE bridge over Hwy 10. Frontage road access will also close at times to construct the bridge connections on the east/west side of Hwy 10. Access will be open and maintained; however, expect changes and follow signs

Pedestrians

Expect sidewalk closures with signed detours. Pedestrians must use designated crossing—E St Germain St., Hwy 23, or 15th Ave./7th St.—please stay out of the Hwy 10 work zone

Ride the Metro Bus

Check your route for changes due to roadwork

Schedule at a glance

Construct

Work

Status

2023 Complete
  • Reconstruct westbound Hwy 23 road, bridge and adjacent entrances
  • Reconstruct eastbound Hwy 10 road and adjacent entrances
  • Construct new Fourth St. bridge and frontage road connections; focus on west side of Hwy 10

2023 work complete

Spring- fall 2024
  • Reconstruct eastbound Hwy 23 road, bridge and adjacent entrances
  • Reconstruct westbound Hwy 10 road/bridge0 road and adjacent entrances
  • Complete the new Fourth St. bridge and frontage road connections
  • Complete drainage, city utilities, curb/gutter, sidewalk/trails, etc., establish turf
  • Wrap-up fall - Remove temporary crossovers and road signs, work off-road

Construct spring to fall 2024

All new lanes, access ramps and bridges to open by fall 2024.

Spring-early summer 2025 Contractor to complete any final tasks Spring-early summer 2025
