Hwy 10, 29 and 71—Wadena

Wadena and Otter Tail counties

Future work, traffic plans

The Wadena project will take three construction seasons to complete from June 2025 to August 2027.

Work by year map

Map of work areas for each year - orange lines are 2026, cyan lines are 2026, dark blue lines are 2027 work.
MnDOT will improve these areas on Hwy 10, 29 and 71. Select map to enlarge.

Schedule at a glance

All information is tentative and subject to change by contractor or MnDOT.

Dates

Map color

Construct

Impacts

April-August 2027

Dark blue

2027 work areas map

Hwy 10 - east of Co. Rd. 20 to Oink Joint Rd.

  • Construct road, medians and entrances, includes roundabout at Harry Rich Dr.
  • Restripe urban portion to four lane from Co. Rd. 20 to Co. Rd. 4
  • Wrap up entire project

Hwy 10

Open one lane, each way

  • Narrow lanes, lane shifts, flaggers
  • No detours at this time

April-late October 2026

Cyan

COMPLETE

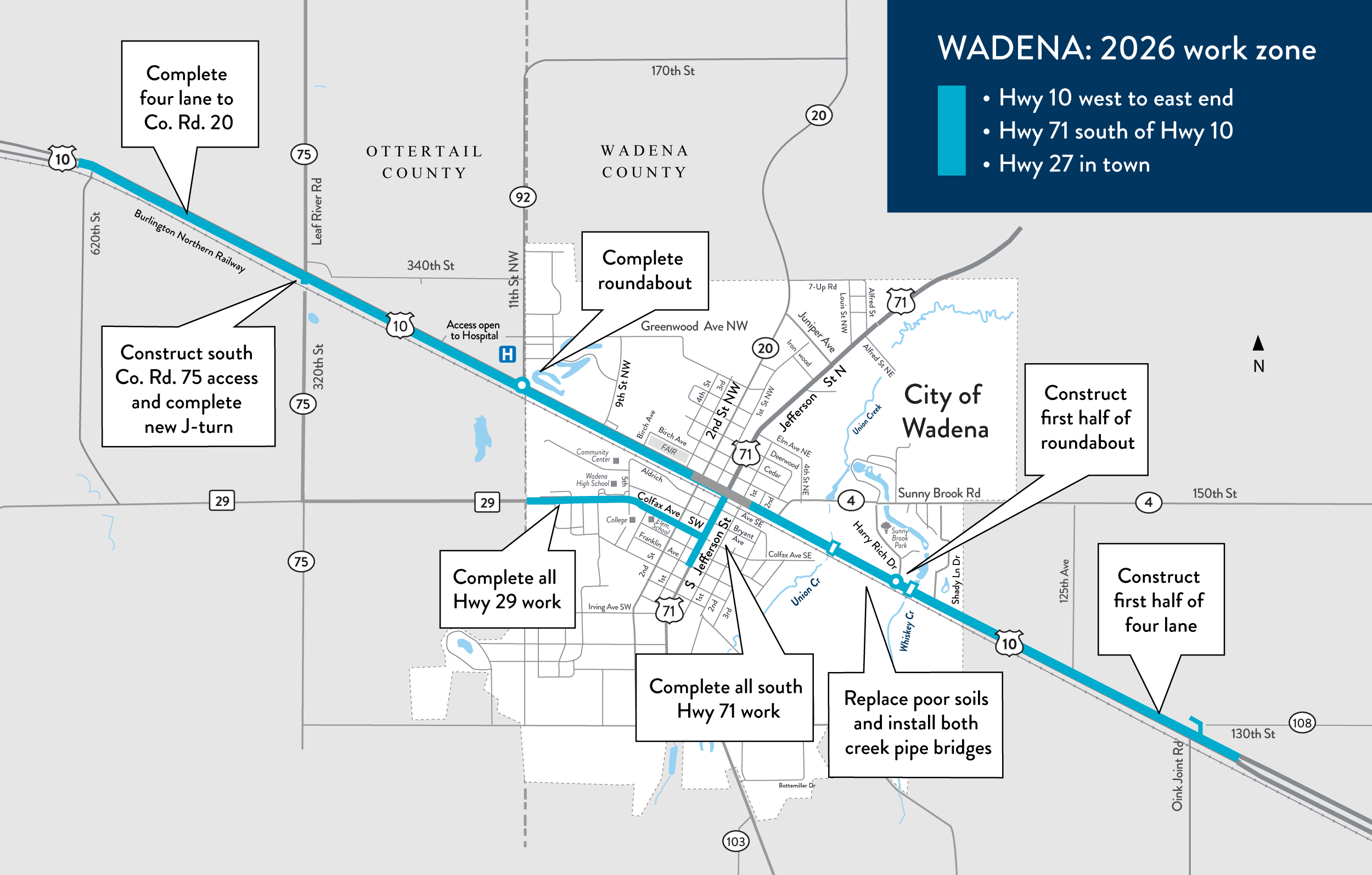

2026 work areas map

Hwy 10

  • West of Hwy 71: Excavate and build up road
    materials; replace pipes; construct road,
    medians and entrances, J-turn at Co. Rd. 75
    and second half of roundabout at hospital (Mid-late April to late October)
  • East of Hwy 71: Excavate and build up road
    materials; construct segments of road,
    entrances, half of roundabout at Harry Rich
    Dr., and box culverts at Union Creek and
    Whiskey Creek (Mid- late April to late October)

Hwy 71 south of Hwy 10

  • Franklin Ave. S to Aldrich Ave. S: Resurface
    the road and update sidewalks and approaches;
    storm sewer work; update or replace signals at
    Hwy 29, Bryant Ave. S, Aldrich Ave. (35 consecutive days within June 22-Sept. 8)

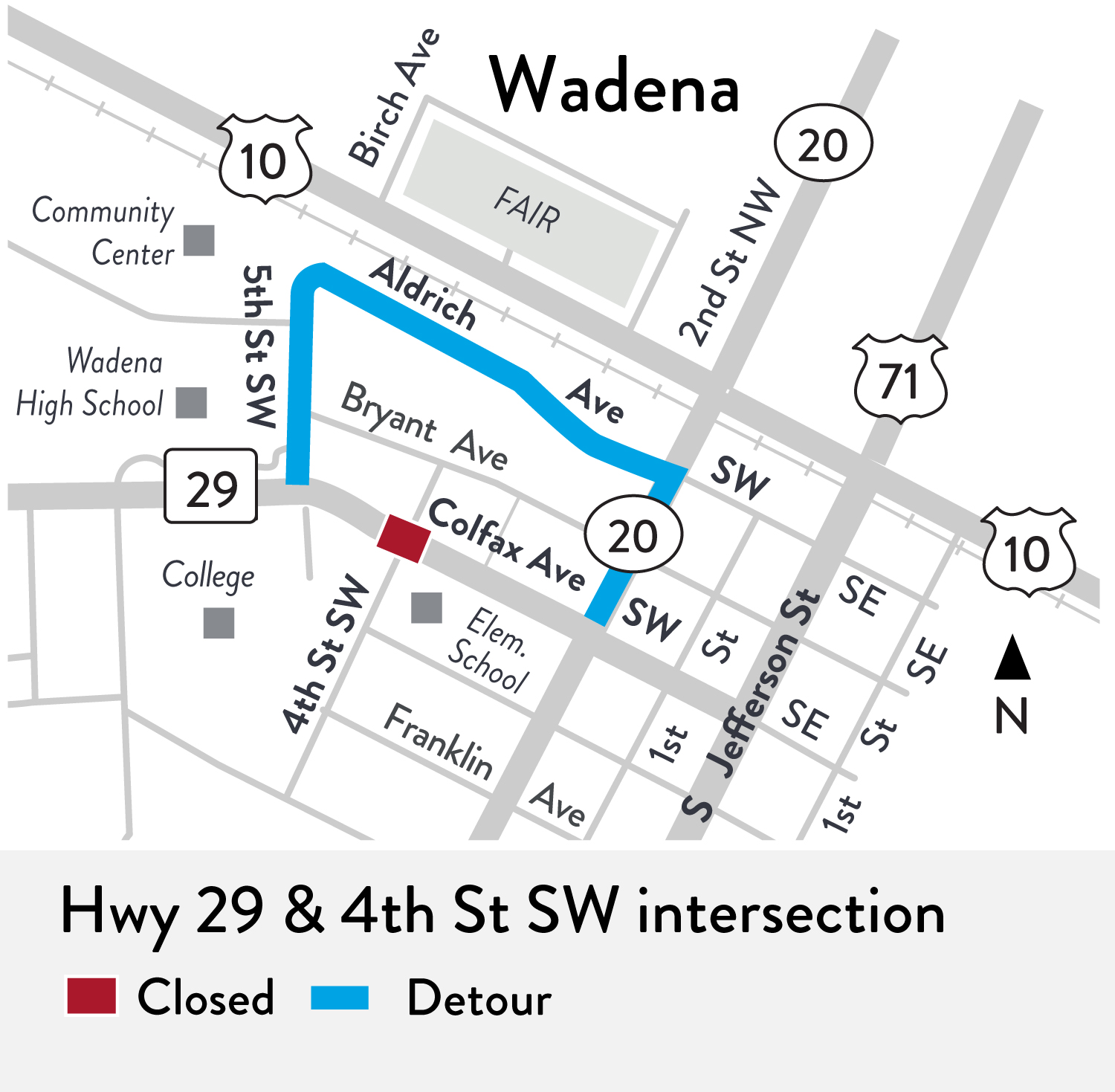

Hwy 29

  • Hwy 71 to west limits of Wadena: Resurface
    road; update/add sidewalk; storm sewer work (40 consecutive days within June 22-Sept. 8)

Complete

June-November 2025

Orange

COMPLETE

2025 work areas map (PNG)

  • Constructed half of new Hwy 10 four-lane west of Hwy 71
  • Reconstructed and improved Hwy 71 north of Hwy 10 with a new road surface, storm sewer and city utilities, turn lanes and sidewalks/trail

Complete
